CONSTRUCTION INFORMATION. Akademiliv provides an overview of the construction project for new premises for the faculty of science and reconstruction work in Medicinarelängan and the Lundberg Laboratory. The University of Gothenburg and Akademiska Hus’s joint picture of the situation on March 23 is that there is currently no impact on the projects based on the spread of covid-19, but the course of events can change quickly. The project follows developments closely. If you have any questions about the construction activities, feel free to email medicinareberget@gu.se.
WEEK 13, March 23 – 27.
Medicinaregatan 14 – replacement premises for parts of the Institute of Biomedicine
Due to the new construction for the Faculty of Science, preparation for replacement premises for parts of the Institute of Biomedicine is ongoing. The former Akademiska Hus operating office is therefore renovated during the spring.
The parking lot continues to be closed due to activities such as asphalting. For additional details view document (Swedish): https://gubox.box.com/s/gyml6y92a171fm0twohmz5deuh1ziggj
Medicinarelängan lower floor – replacement premises for CCI
Reconstruction is ongoing in order to prepare for docking the new building for the Faculty of Science and to provide temporary premises for Center for Cellular Imaging, CCI, who will move from 7A to Medicinaregatan 1F. See map for details in attached document. (Swedish): https://gubox.box.com/s/6u26fb6e95rhxtvsvtxd75dvfnkc3k5w
Modules at the Lundberg laboratory – replacement premises for parts of Core Facilities
Deliveries of lab furnishings remains to be completed. The work will not to cause any disturbances in the surrounding area. Hence, the reporting from this activity ends.
Lundberg laboratory – replacement premises for parts of the Institute of Biomedicine
Delivery of lab furnishings for the third and fourth floor continues. Half of the second floor is under reconstruction. A space between the Lundberg laboratory and Medicinarelängan is occupied for containers and materials. See map with details in this document: https://gubox.box.com/s/g7w127ruueuoph3x9kusu8y1x71rw5ml
Natrium
The work on removing the remaining rock closest to Medicinarelängan is proceeding. The wooden plank adds additional protection and keeps some noise away for those closest to the construction site. On Friday the week before last week, it was moved in the direction of Nya Forsken to be properly placed for this week’s work.
Different methods are used to clear the surface from soil and vegetation. Thereafter holes are drilled both for reinforcement and for the Thursday blast. In parallel, work is done to a support wall adjacent to the EBM media center.

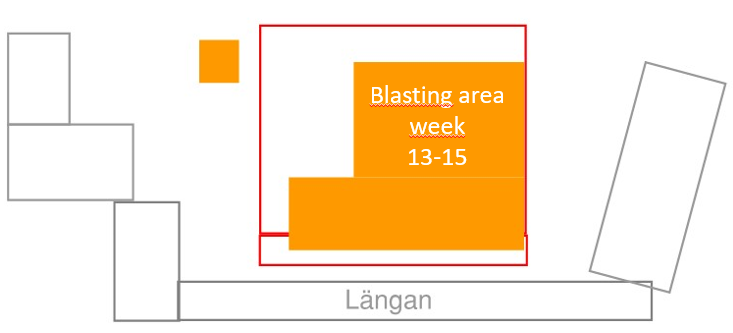

Tuesday’s blast takes place in the center of the area on the fourth level according to the figure below.
Blasting in week 13 will take place Tuesday and Thursday at 12.30 with reserve time at 15.00 on the same days. On Thursday, the reserve time will be used to divide some large boulders to enable outloading. This kind of blast usually causes sound but no major vibrations. In addition, this blast is preceded with the usual warning signal.
WEEK 14, March 30 – April 3.
Medicinaregatan 14 – replacement premises for parts of the Institute of Biomedicine
Due to the new construction for the Faculty of Science, preparation for replacement premises for parts of the Institute of Biomedicine is ongoing. The former Akademiska Hus operating office will therefore be renovated during the spring.
The parking lot continues to be closed due to construction related activities such as asphalting. For additional details view this document (Swedish): https://gubox.box.com/s/gyml6y92a171fm0twohmz5deuh1ziggj
The final inspection of the reconstruction work is scheduled in week 14.
As the construction related activities by this are finalized, the reporting from this projects ends here. Note that occupancy is completed later.
Medicinarelängan lower floor– replacement premises for CCI
Reconstruction is ongoing in order to prepare for docking the new building for the Faculty of Science and to provide temporary premises for Center for Cellular Imaging, CCI, who will move from 7A to Medicinaregatan 1F. See map for details in this document (Swedish): https://gubox.box.com/s/6u26fb6e95rhxtvsvtxd75dvfnkc3k5w
The final inspection of the reconstruction work is scheduled in week 14.
As the construction related activities by this are finalized, the reporting from this projects ends here. Note that occupancy is completed later.
Lundberg laboratory – replacement premises for parts of the Institute of Biomedicine
Delivery of lab furnishings for the third and fourth floor continues. Half of the second floor is under reconstruction. A space between the Lundberg laboratory and Medicinarelängan is used for containers and materials. See map with details in this document: https://gubox.box.com/s/g7w127ruueuoph3x9kusu8y1x71rw5ml
Natrium
In week 14, preparation work starts for the temporary modules that will be the home base for the project office, changing rooms and lunchroom for the construction team. The modules will be placed on the parking space next to Occupational and Environmental Medicine. See image for the location: https://gubox.box.com/s/dlkd7c867r1gsc0b4k8ly6ew1yye3pgo
The assembly area used at emergencies will remain so far. The preparations is largely about making room for installations of electricity, water supply and drain and extending the area a bit toward the slope. The modules will arrive in a couple of weeks and are to be ready for occupancy by June.
As for the construction site, the project has once again moved the wooden plank along the facade of Mediccinarelängan to prepare for a new blast near the facade on Thursday. Tuesday’s blast takes place in the middle of the pit and applies to the fourth pallet level. Otherwise, the work on the support wall at EBM’s media center ends with a final reinforcement work.
Blasting in week 13 will take place Tuesday and Thursday at 12.30 with reserve time at 15.00 on the same days.
WEEK 15, April 6 – 10.
Lundberg laboratory – replacement premises for parts of the Institute of Biomedicine
Delivery of lab furnishings for the third and fourth floor continues. Half of the second floor, is under reconstruction. A space between the Lundberg laboratory and Medicinarelängan is used for containers and materials. See map with details in this document: https://gubox.box.com/s/g7w127ruueuoph3x9kusu8y1x71rw5ml
Natrium
Preparatory groundwork for the modules close to Occupational and Environmental Medicine continues in week 15. On the construction site both blasts in the week will be carried out in the center of the area and on level four, however there will be some preparation work made close to the facade of Medicinarelängan.
Blasting in the week will take place Tuesday and Thursday at 12.30 with reserve time at 15.00 on the same days.
In the Staff Portal you will find more information about construction projects on Medicinareberget: https://medarbetarportalen.gu.se/sahlgrenskaakademin/byggprojektmedicinareberget/
